Kilroy Oyster Point - Waterside Logistics Plan

February 11, 2020

For Your Reference: KOP Waterside Logistics Plan

To Members of the Oyster Point Marina Community,

In preparation for the construction work starting at the marina this summer, we are providing our Waterside Logistics Plan for your reference. The approximate timeline for this work is as follows:
Phase 1A  July 2020 - August 2020
Phase 1B  August 2020 - December 2020
Phase 2    December 2020 - May 2021

Contains image of Oyster Point Marina

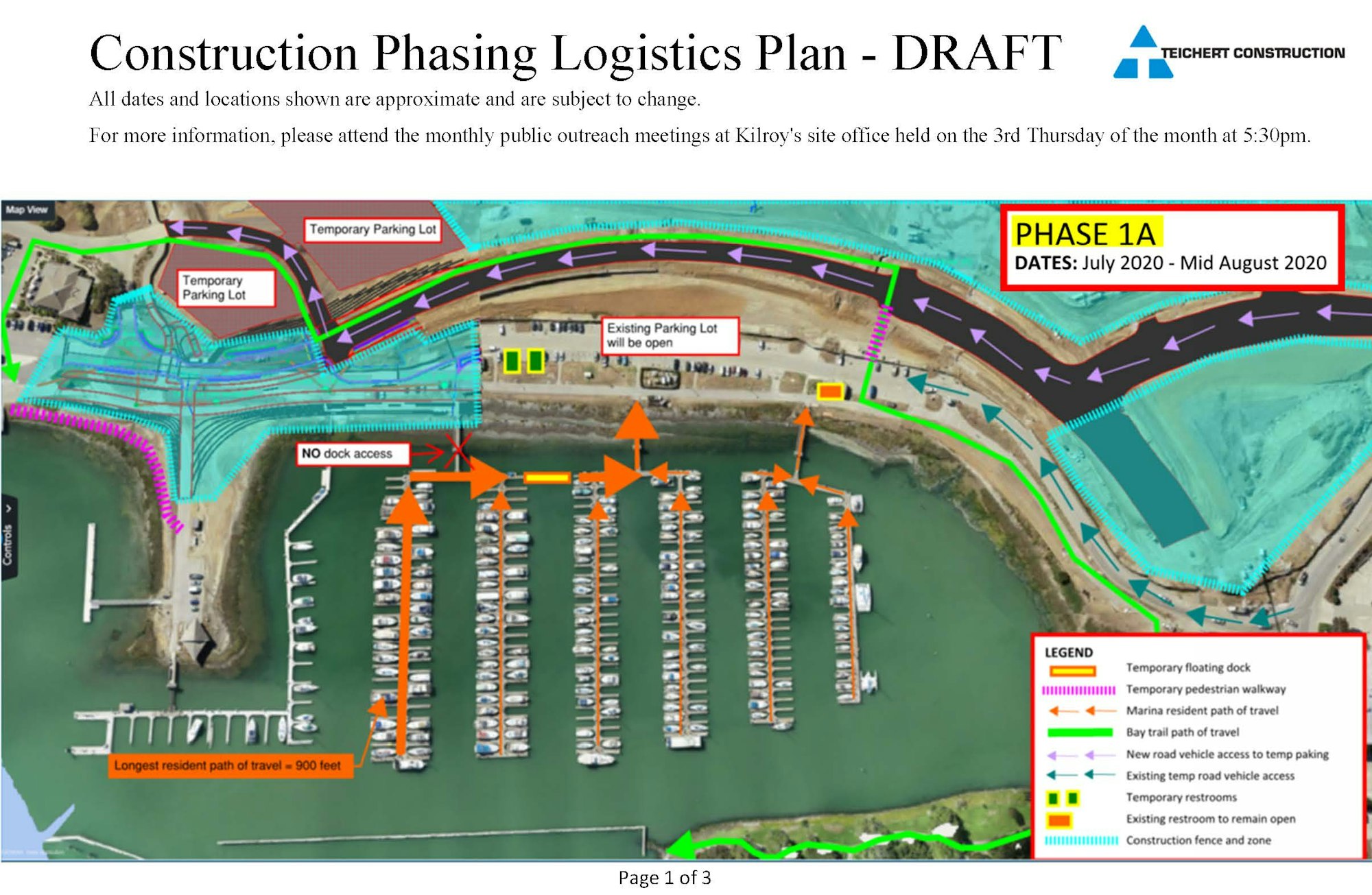

Phase 1A  July 2020 - August 2020
Construction phasing plan showing temporary parking, dock access changes, and public meeting info. Designated dates included.

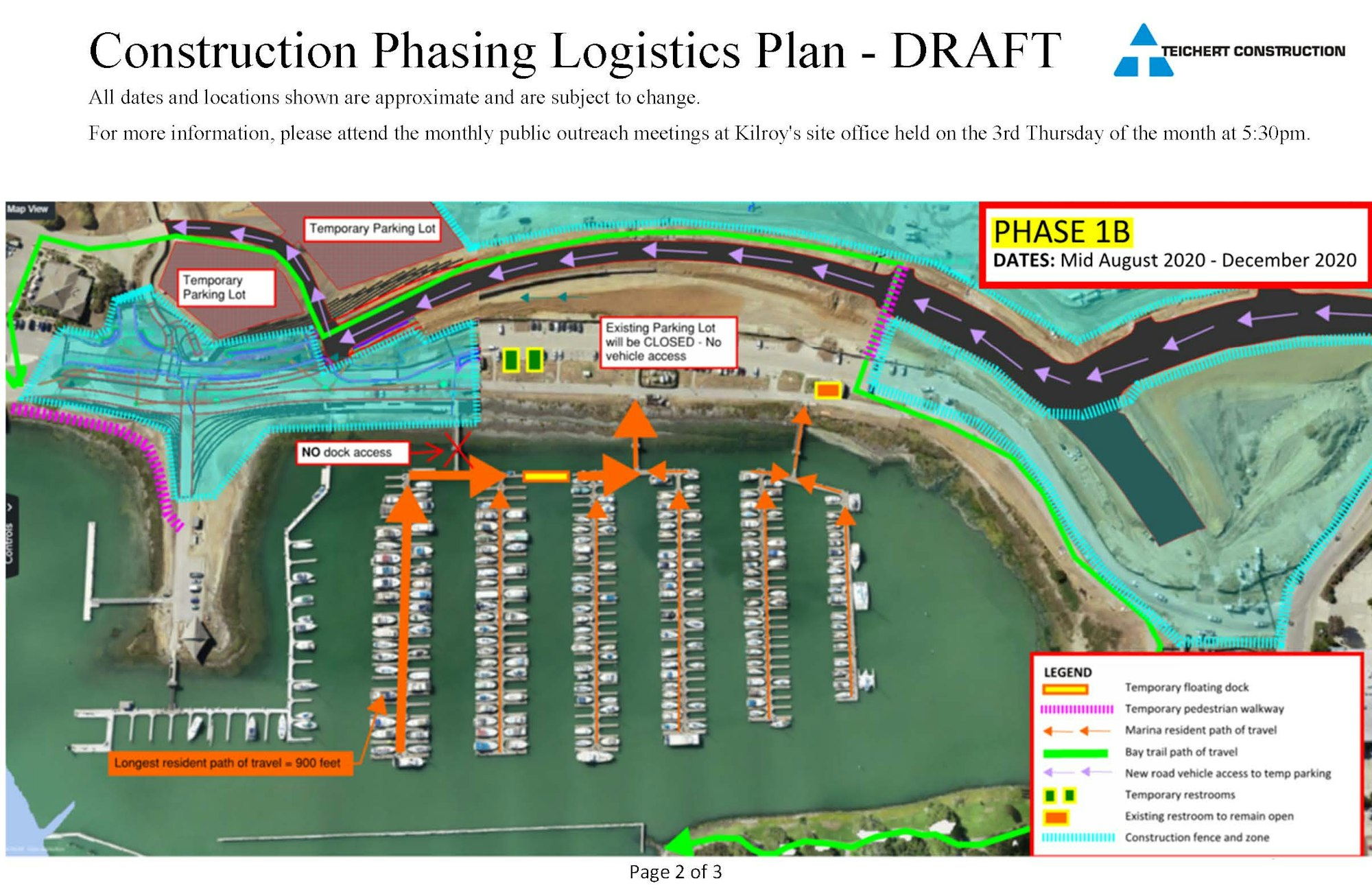

Phase 1B  August 2020 - December 2020
Contains image of Oyster Point Marina
Phase 2    December 2020 - May 2021


We welcome any questions or comments you may have.
